Transport, Quantity Surveying

Mangamuka Gorge Slip Repair

Stellar Projects   Mangamuka Gorge Slip Repair
Location Mangamuka Gorge, Northland
Timeline 2023–2026
Client NZ Transport Agency Waka Kotahi (NZTA)

SERVICES PROVIDED — Project management
— Cost management & commercial governance
— Contract administration
— Engineer to Contract / Engineer’s Representative
— Principal Quantity Surveying

When record‑breaking rainfall hit Te Tai Tokerau Northland in August 2022, the Mangamuka Gorge on State Highway 1 suffered catastrophic landslip damage. Fifteen slips — six classified as critical — forced the immediate closure of a 13‑kilometre lifeline route connecting communities, freight, and essential services in the Far North.

What followed became one of New Zealand’s most complex infrastructure recovery projects, combining emergency response, long‑term resilience planning, environmental stewardship, and deep community engagement.

NZ Transport Agency Waka Kotahi engaged Stellar Projects to provide project management, cost management, and contract administration services across the recovery programme.

After nearly three years of intensive work, the gorge reopened in December 2023, with final strengthening completed in early 2025, restoring a safer, more resilient corridor for generations to come.

The Challenge

Recovery works commenced in February 2023, under constantly changing site conditions that required real‑time decision‑making and adaptive delivery models.

The Mangamuka Gorge has long been recognised as geologically unstable, with a history of slips exacerbated by extreme weather events. Following the August 2022 storm:

  • Slip numbers escalated from 15 to 36 during construction
  • Annual rainfall exceeded 2.8 metres, over 1,000mm above average
  • Unstable ground conditions delayed access, equipment mobilisation, and piling works
  • Communities were isolated, freight routes disrupted, and political pressure intensified

Engineering & Geotechnical ComplexityThe scale and unpredictability of the terrain demanded exceptional engineering coordination.

Key Technical Challenges

  • Highly variable geology, with pile depths ranging from 16 to over 30 metres within metres of each other
  • Collapsing boreholes during pile drilling
  • Ongoing storm events that more than doubled the scope mid‑construction
  • Full road closures required for major concrete pours

Delivered Solutions

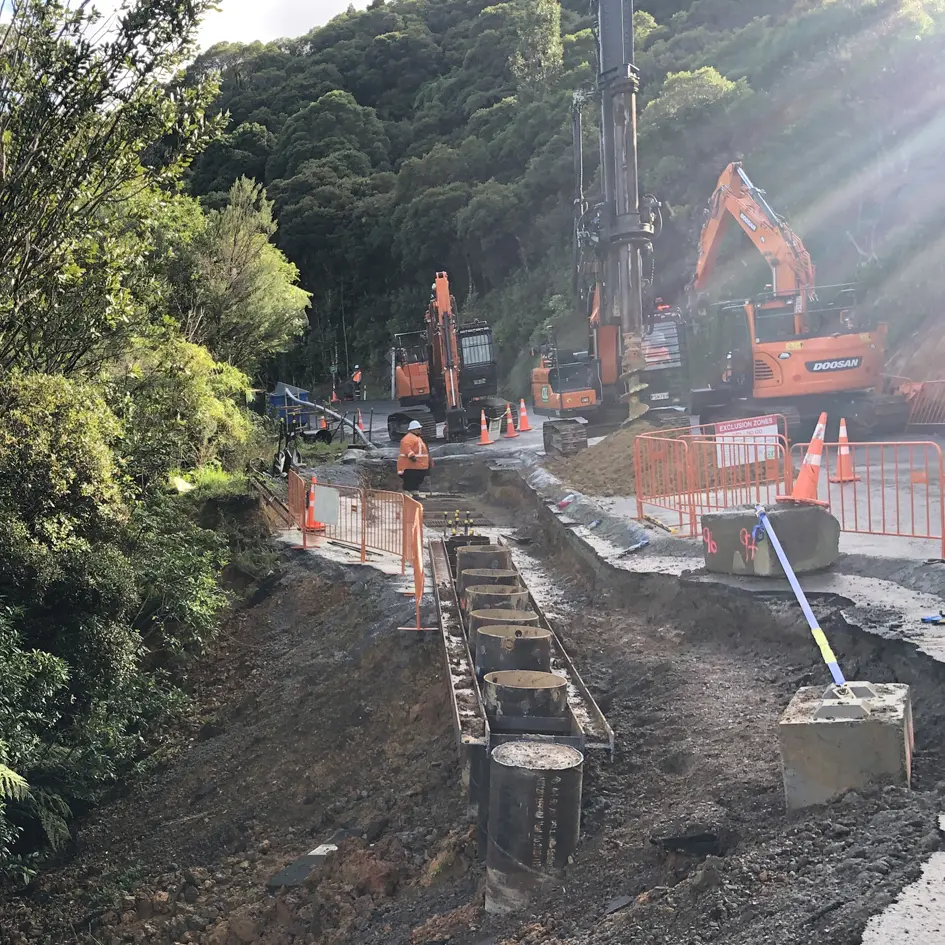

  • 747 enabling piles and 300+ permanent piles installed
  • Anchors drilled up to 40 metres into unstable slopes
  • Bore drains extending up to 99 metres to relieve pore water pressure
  • Large‑scale retaining structures using precast concrete and timber lagging
  • Innovative reuse of recycled timber and surplus piles to mitigate supply‑chain delays

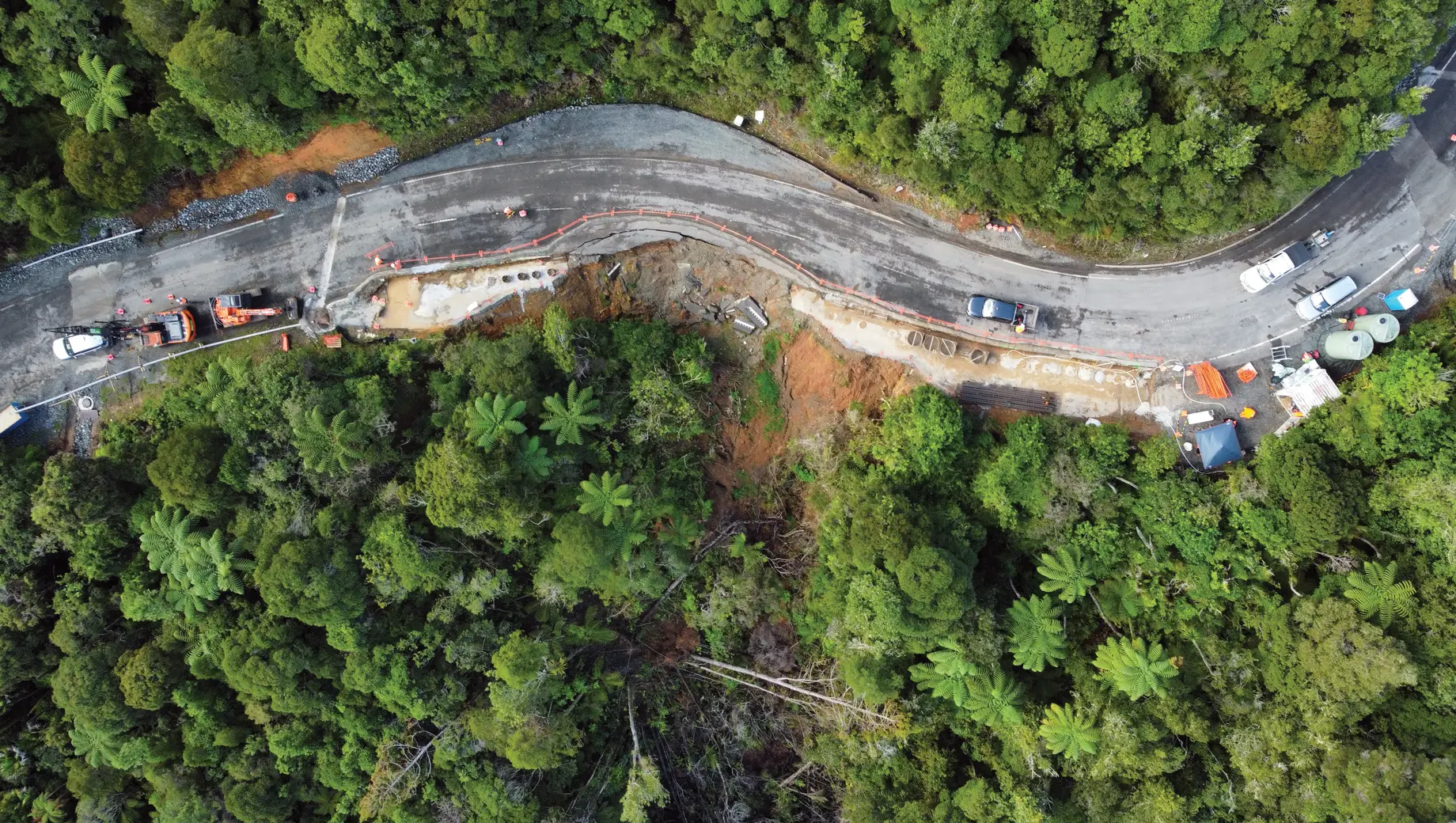

One of the most complex sites, Slip A11, required excavation of over 35,000 cubic metres of material — stabilising the slope while enabling potential future realignment of SH1.

Environmental & Ecological ManagementLocated within a scenic reserve, the project intersected with wetlands, sensitive freshwater systems, and protected habitats. Environmental management became a parallel programme of work.

Key Environmental Outcomes

  • Environmental DNA sampling identified endangered species, including rare lichen
  • Design revisions protected sensitive habitats
  • Culvert upgrades delivered over 4km of new fish habitat
  • Award‑winning sediment control systems reduced runoff impacts
  • Extensive compliance under the RMA, Wildlife Act, Fisheries Act, and Heritage NZ Act

Despite emergency works provisions, the project required:

  • 18+ resource consents
  • Wildlife permits and conservation concessions
  • Retrospective approvals for ongoing works

Ecological constraints — including bats and rare native snails — added up to nine months of permitting lead time, influencing construction sequencing.

Community & Cultural Partnership

The Mangamuka Gorge recovery became a community‑anchored project, not just an engineering one.

  • Local iwi collaborated on the design and installation of cultural gateway pou
  • Dawn blessings, haka, and community ceremonies marked key milestones
  • Proactive engagement through newsletters, school visits, markets, videos, and site tours
  • Clear, accessible communication built trust and public understanding

Many contractors were local, with others relocating permanently—embedding the workforce within the community it served.

Stellar Projects   Mangamuka   2

Outcomes & Legacy

Outcomes & LegacyBy early 2025, the project had delivered:

  • 36 slips repaired across 13km of State Highway 1
  • Major retaining, drainage, and pavement reconstruction works
  • New stormwater systems and safety barriers
  • Cultural installations and public art
  • Award‑winning environmental controls and fish passage improvements
  • Ongoing monitoring systems for long‑term resilience

While the gorge remains geologically dynamic, it is now significantly more resilient, better monitored, and safer for road users and communities.
